Home / Custom Plush OEM / Pre-Production Checklist

Pre-Production Approval Guide

Custom Plush Pre-Production Checklist

Custom plush pre-production checklist for approving the master sample, specifications, BOM, tolerances, packaging, barcodes, carton data and first production units.

Before custom plush production starts, freeze not only the approved sample but also measurement points, expression, colors, fabric, embroidery, accessories, packaging, labels, carton quantity and delivery references under one version.

Short answerBefore custom plush mass production, compare the approved master sample with the current specification, material and color references, component BOM, packaging instructions, label files and carton data. Record open items, approver, approval date and final revision. Where safety, barcode or destination rules apply, confirm the required checks before releasing the production line.
Approved SampleSpecs and ColorPackaging and LabelsCartons and Delivery

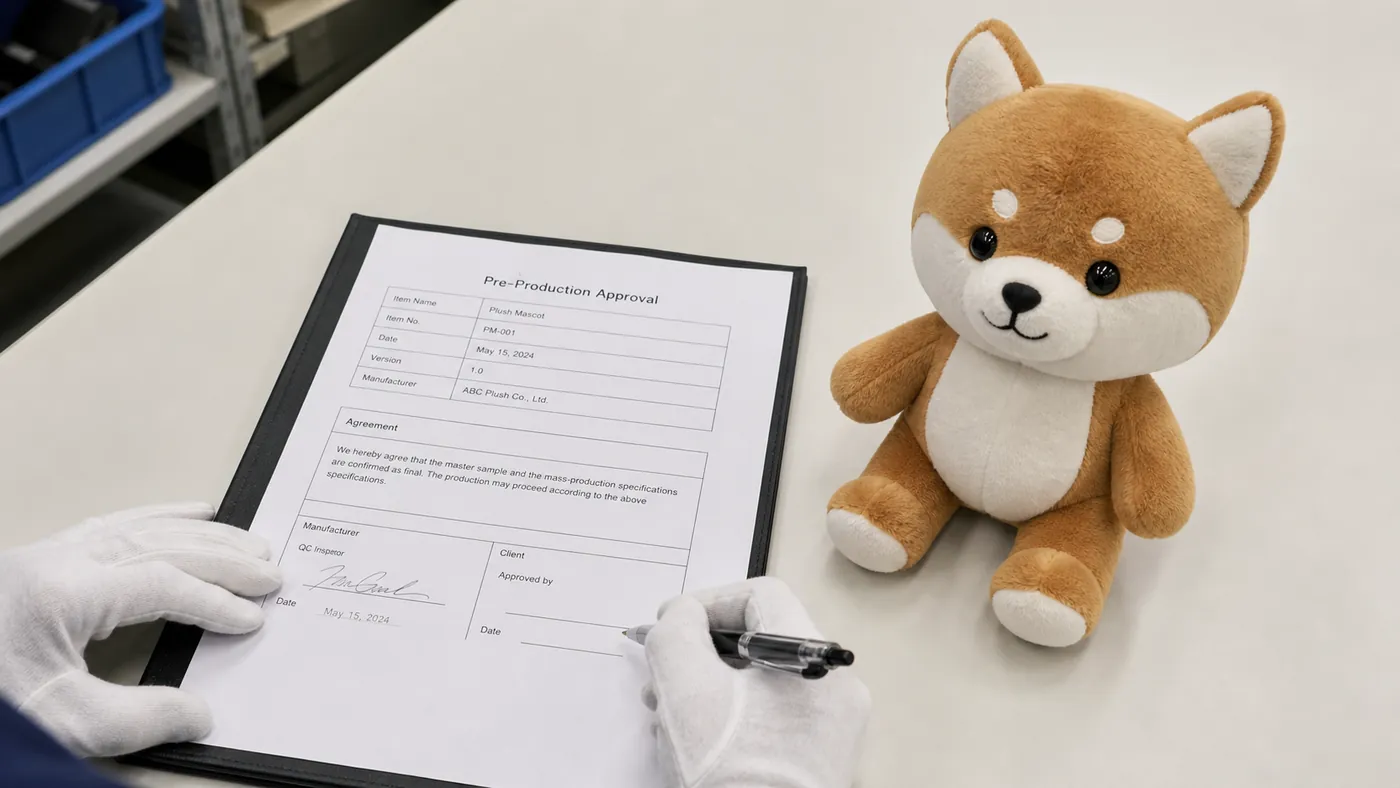

signed pre-production approval document beside the approved plush master sample

Six approval groups to freeze before production

Compare the approved product, production specification, packaging and delivery instructions against physical references under one revision.

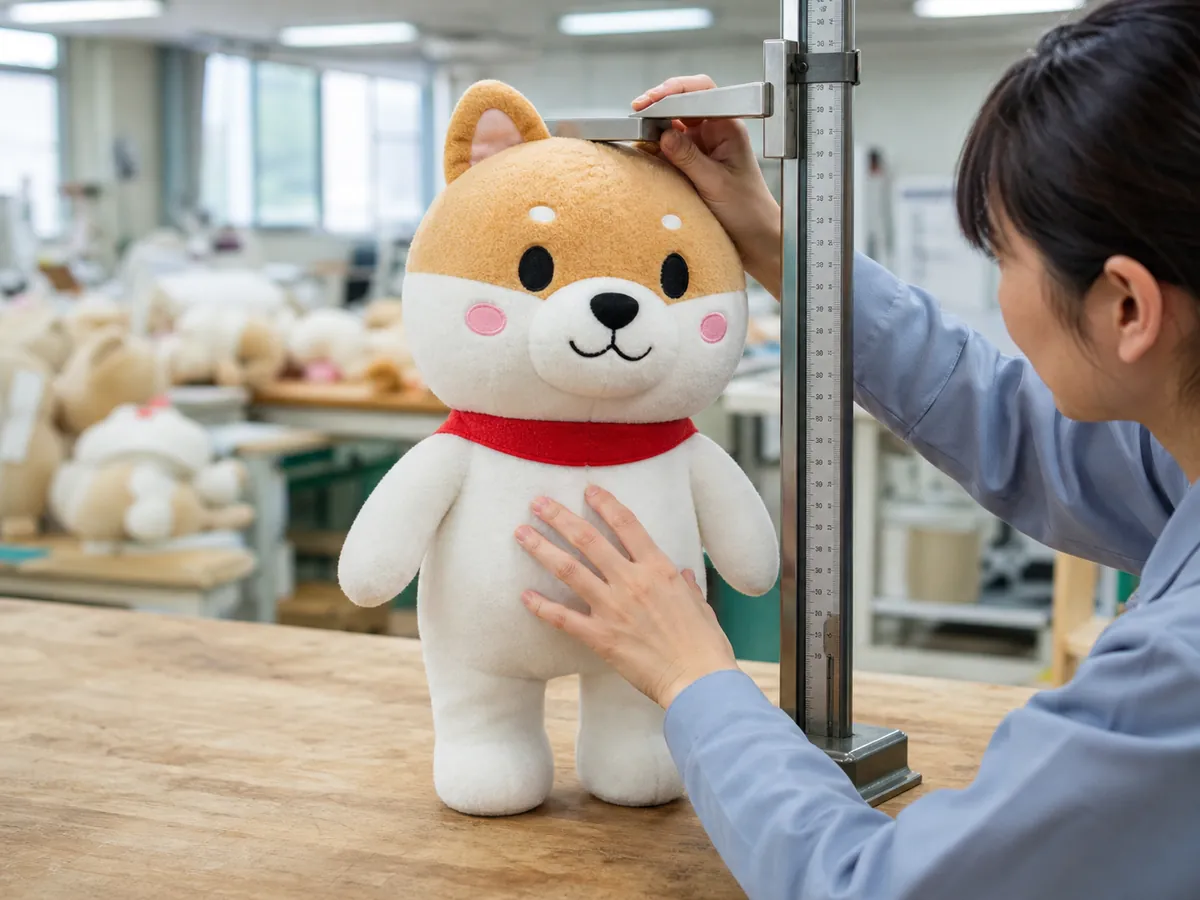

plush mascot height and posture checked with a vertical height gauge
1. Size and shape

Measure total height, width, depth and seated height from consistent reference points, then check filling level and standing or seated posture.

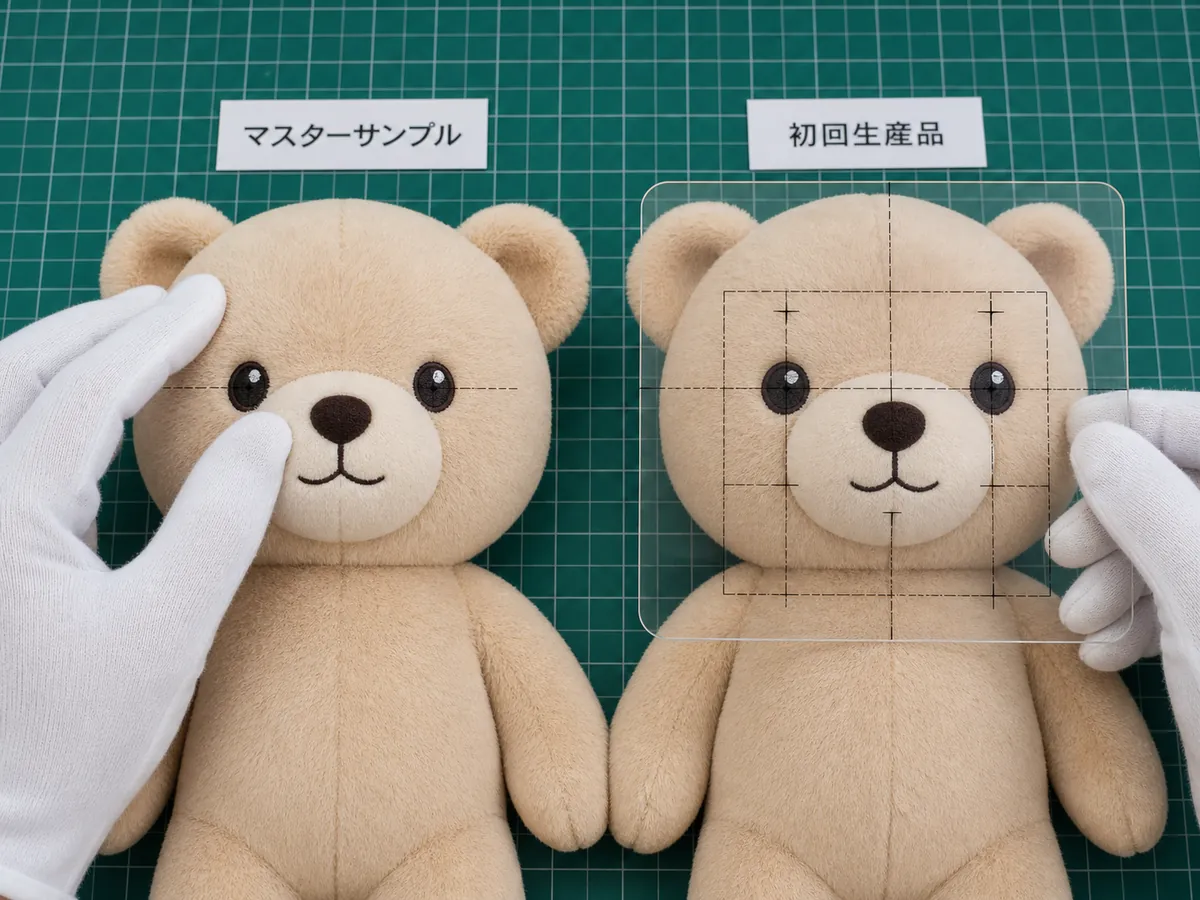

approved plush master sample compared with the first production unit for facial embroidery placement
2. Face and embroidery

Compare the master sample and placement reference for eyes, nose, mouth, embroidery position and line width.

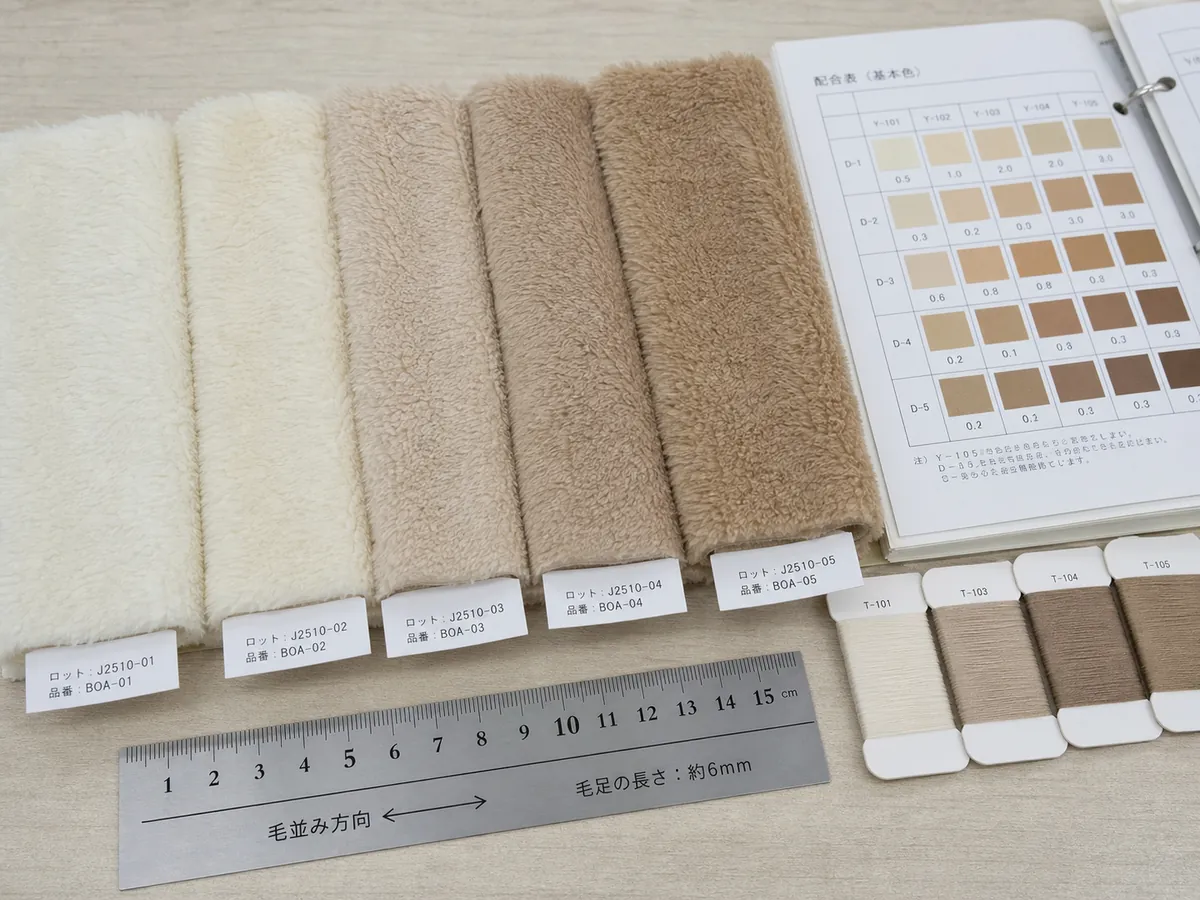

plush fabric code pile direction and embroidery thread color verification
3. Color and fabric

Freeze the production plush fabric code, color, pile direction and embroidery thread against approved swatches.

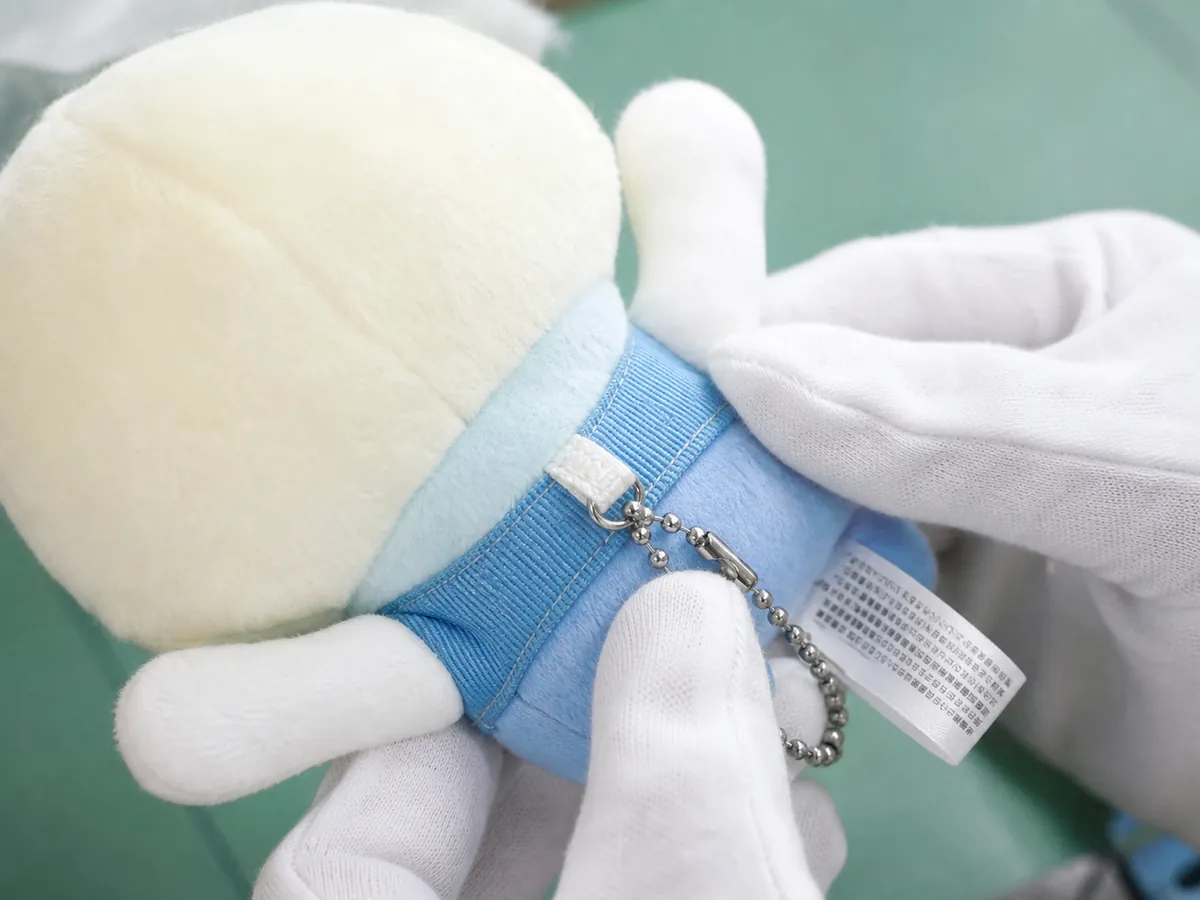

reinforced sewing at the plush ball chain attachment point
4. Accessories and sewing

Check ball-chain attachment tape, garment seams, reinforcement and sewn-label positions against the specification.

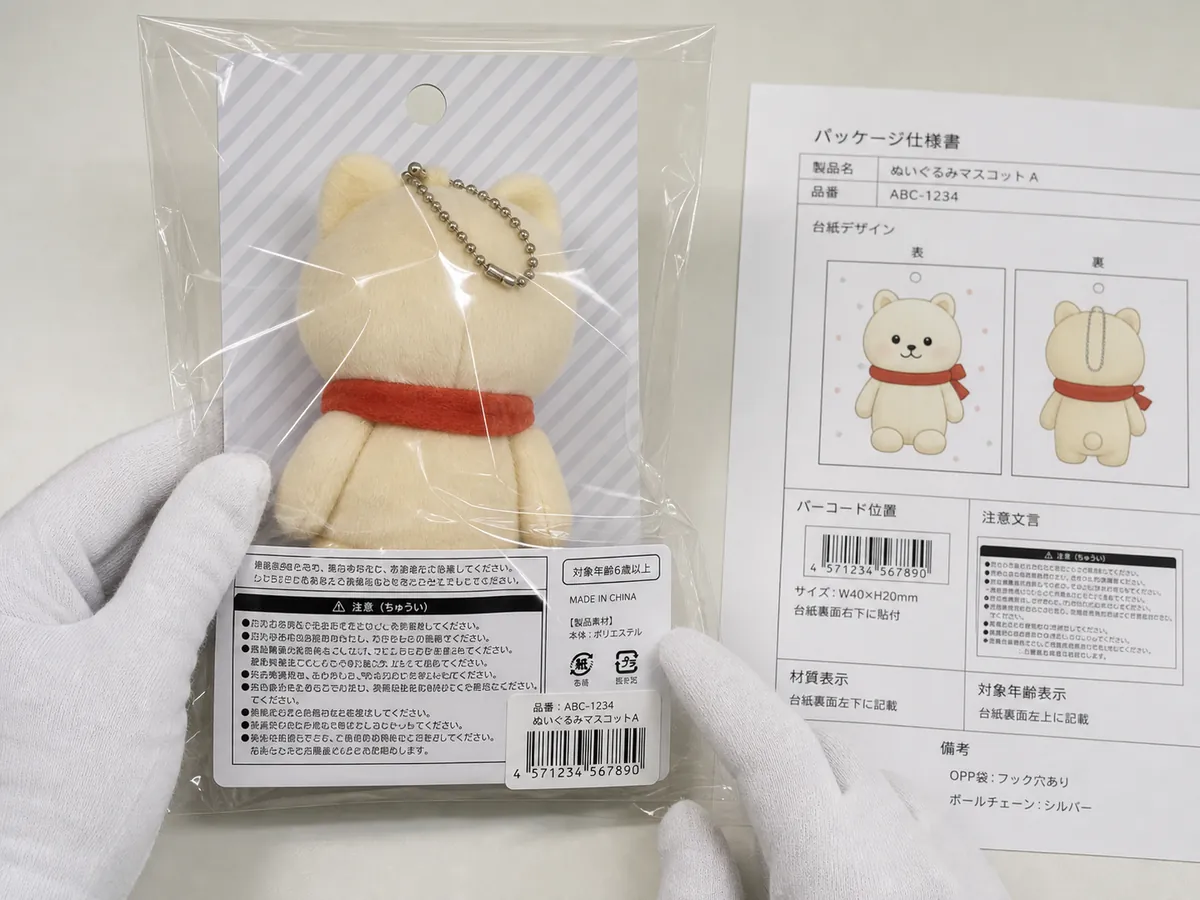

custom plush OPP packaging backing card barcode and warning label check
5. Packaging and labelling

Verify the OPP bag, backing card, JAN or barcode, warning labels, inserts and packing orientation.

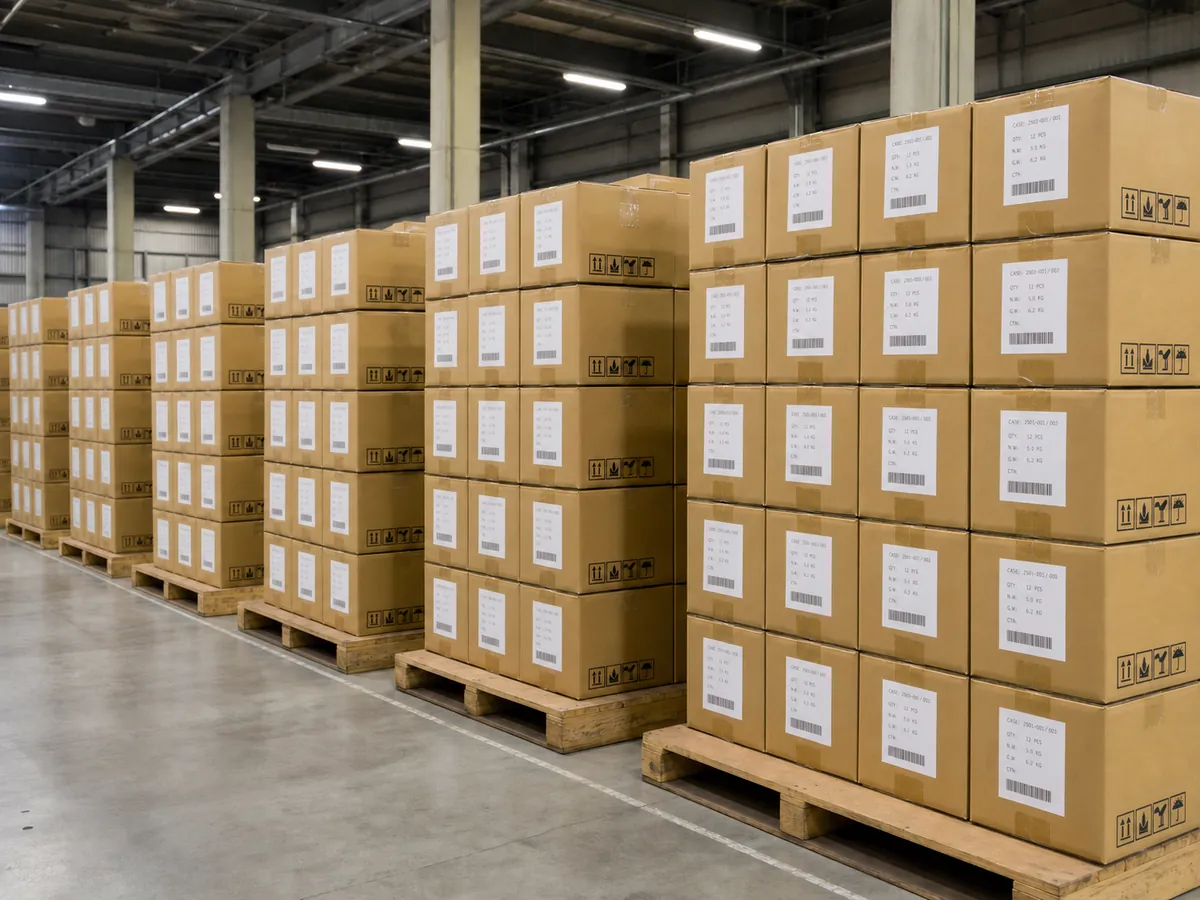

unattended warehouse cartons with case numbers and generic shipping labels
6. Cartons and delivery

Confirm case numbers, units per carton, generic shipping labels and handling marks without exposing personal names or addresses.

Use the same measuring points and approved references across the supplier, inspector and buyer team. Project tolerances vary with product size, construction, safety requirements and sales channel.

Final checklist before custom plush production

Combine the check item, approval reference, record and commonly missed difference in one table.

Check groupWhat to checkApproval referenceRecordCommon miss
Size and shapeHeight, width, depth, sitting height, posture and fillingApproved sample, dimension drawing and measuring pointsMeasurement photos, values and toleranceGate Different people measure from different points
Expression and embroideryEyes, brows, mouth, outline, thread, width and positionFront artwork, embroidery file and approved photosFront and angle photos, thread codesGate Expression changes by angle or left-right balance
Color and fabricFabric code, pile, direction, color combination and lotSwatches, color codes and approved versionPhysical reference, codes and combination tableGate Color name is used without a material reference
Accessories and sewingHardware, tags, clothing, reinforcement and seamsParts list, position drawing and samplePart photos and appearance recordsGate A component change is missing from the specification
Packaging and displayOPP, card, barcode, warnings, SKU label and orientationPackaging instruction, print files and SKU tablePacking sample, proof and label versionGate Old artwork or another SKU label is used
Cartons and deliveryQuantity, case number, carton marks and destinationCarton detail, delivery instruction and address listCarton photo, weight, dimensions and dispatch sheetGate Carton contents differ from the outer mark
Do not move open items into production as blank fields. Record the owner, due date and affected scope. When a change is approved, update the sample reference, specification, packaging and label files under the same revision.

Original Flow: From Approved References to Production Freeze

Match the product, materials, accessories, packaging and carton data before freezing the production version.

Four fields to keep in the approval record

Record exactly which files and sample were approved, by whom and when.

Approval target

Identify the sample number, specification, photos and packaging files.

Revision number

Record replacement date and current version to prevent old-file use.

Open items

Name the owner, due date and effect on production.

Approver and date

Keep the final approver, approval date and conditional approval details.

Four final audit gates before mass production

Release the production line only after approval records, components, logistics labels and safety-check preparation are confirmed.

signed pre-production approval document beside the approved plush master sample
Master sample and production approval

Record the approval target, revision, approver, approval date and any conditional approval under the same project version.

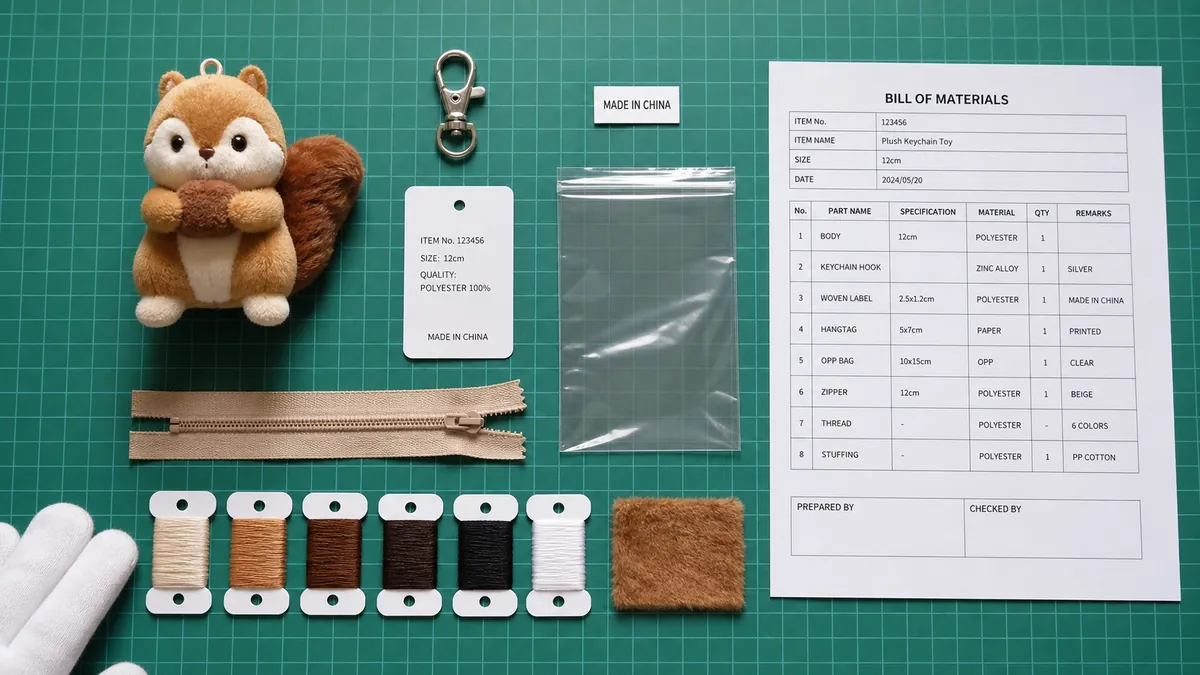

metal hook woven label hangtag and OPP bag checked against the plush BOM
Full component and attachment check

Compare hardware, woven labels, hangtags, bags, thread and other secondary materials against the approved BOM.

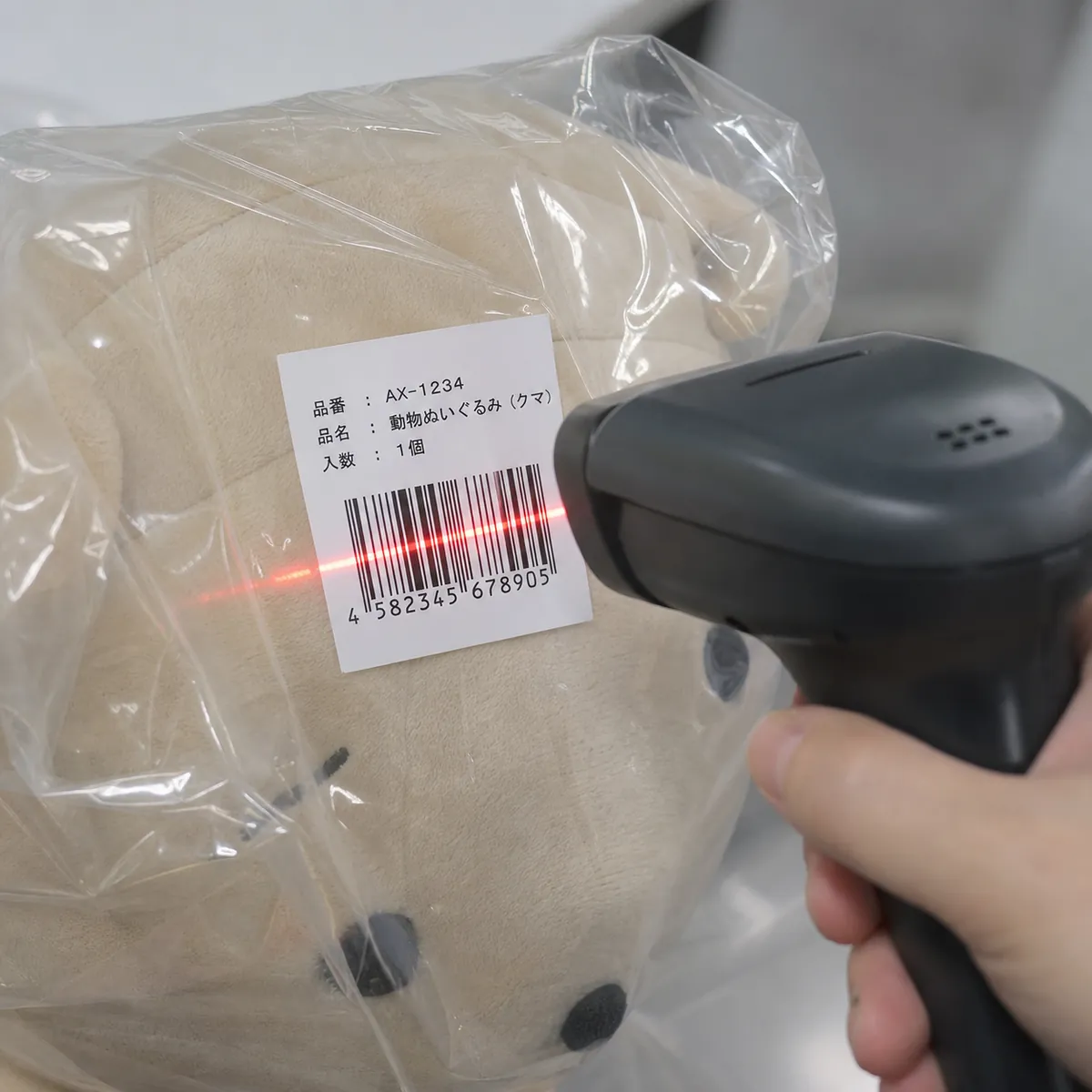

JAN barcode scan test on a packaged custom plush mascot
JAN and barcode scan test

Test the actual printed barcode before production and verify the SKU, code, backing card and packaging combination.

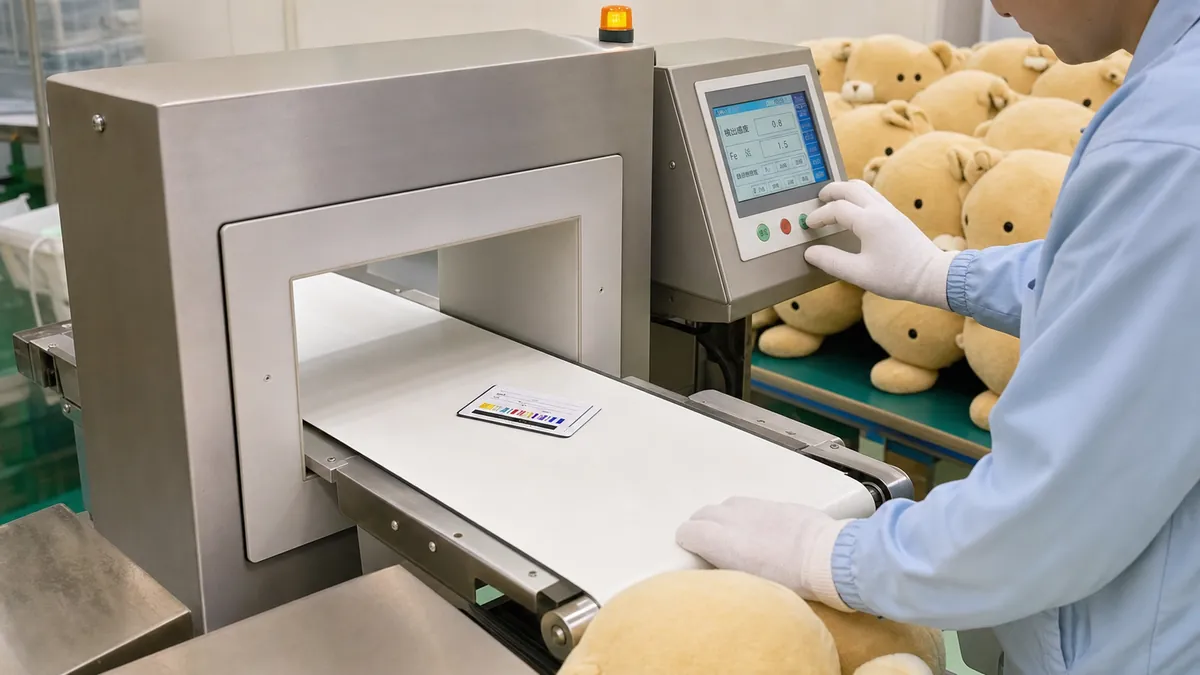

needle detector sensitivity check with a calibration test piece
Safety and needle-detection preparation

Where required by the product and destination, confirm detector operation and sensitivity with an agreed calibration test piece.

Three control rules that prevent production drift

Prevent unauthorized material substitutions, inconsistent tolerance decisions and first-day line deviations before full production continues.

01

Register a component master BOM

List the manufacturer, model or specification, material and color reference for zippers, woven labels, ball chains and other secondary materials. Only approved components should be released to the production line.

02

Agree measurable tolerance limits

Sewn plush products include manual processes and natural variation. Define the measuring method and pass/fail limits for facial placement, finished dimensions, thickness and filling firmness—for example, an agreed left-right placement tolerance where appropriate.

03

Run first-article inspection

Sample the first units produced on day one and compare them with the master sample, BOM and packaging specification. Continue full production only after the agreed first-bulk quantity passes the review.

Files to prepare for production approval

Manage product, material, packaging and delivery references under the same project and revision identifiers.

Product reference
  • Approved sample number
  • Dimension drawing and points
  • Expression and embroidery files
Materials and parts
  • Fabric and thread codes
  • Hardware, tags and accessories
  • Alternative-material condition
Packaging and display
  • OPP, card and barcode files
  • Warnings and inserts
  • Packing sample by SKU
Cartons and delivery
  • Carton quantity and case number
  • Outer-carton label
  • Destination, split and warehouse rules

Related pages

Use this checklist with sample revisions, approvals, materials, packaging, inspection and delivery planning.

FAQ

What should be checked before production starts?

Match the approved sample and specification for dimensions, expression, color, fabric, embroidery, accessories, packaging, labels, carton quantity and delivery conditions.

Is sample approval alone enough?

Also freeze the dimension drawing, material codes, embroidery files, packaging and label versions, and carton details used by production.

Can color be approved from a screen image?

Screen appearance varies. Use swatches, thread codes or a physical sample as the project-specific color reference when needed.

What happens if a specification changes before production?

Record the change, affected SKUs, packaging and inspection points, define the recheck method, and update the approved files and revision.

Does the checklist guarantee zero defects?

No. It reduces missed confirmations but cannot guarantee zero defects. Define project inspection criteria, sampling method and tolerances separately.

What should be shared for an inquiry?

Share the approved sample, specification, SKU count, quantity, materials, accessories, packaging, labels, cartons, inspection needs and destination.
